Semmering Base Tunnel

THE SEMMERING BASE TUNNEL IS EUROPE’S MOST IMPORTANT INFRASTRUCTURE PROJECT. FOR ITS IMPLEMENTATION, SWIETELSKY RELIES ON ITS EXTENSIVE EXPERIENCE.

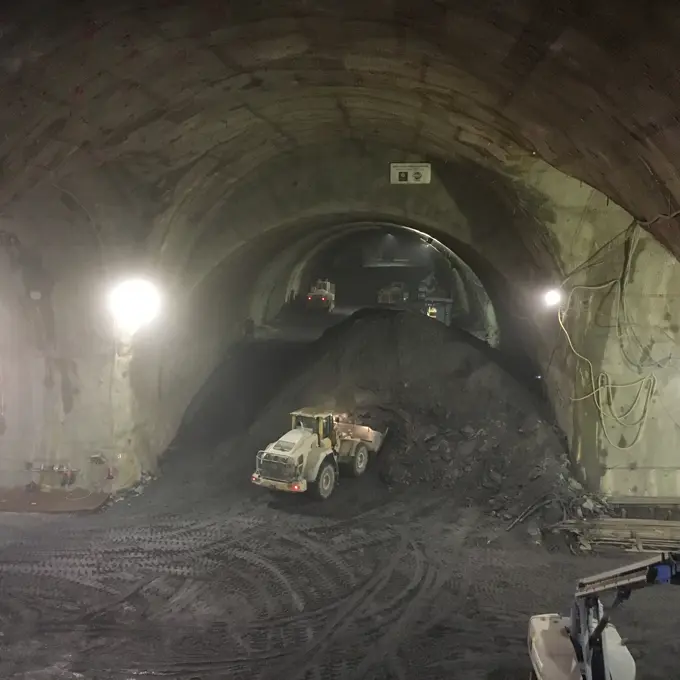

At the end of 2025, the final construction phase of this 27.3-kilometre mega-project began. The tunnel tubes have been 100% excavated, more than 50 of the total 55 kilometres of internal concrete lining across both tubes have already been cast, and railway systems installation is underway.

260610 Semmering Basistunnel AT (C)SWIETELSKY (2)

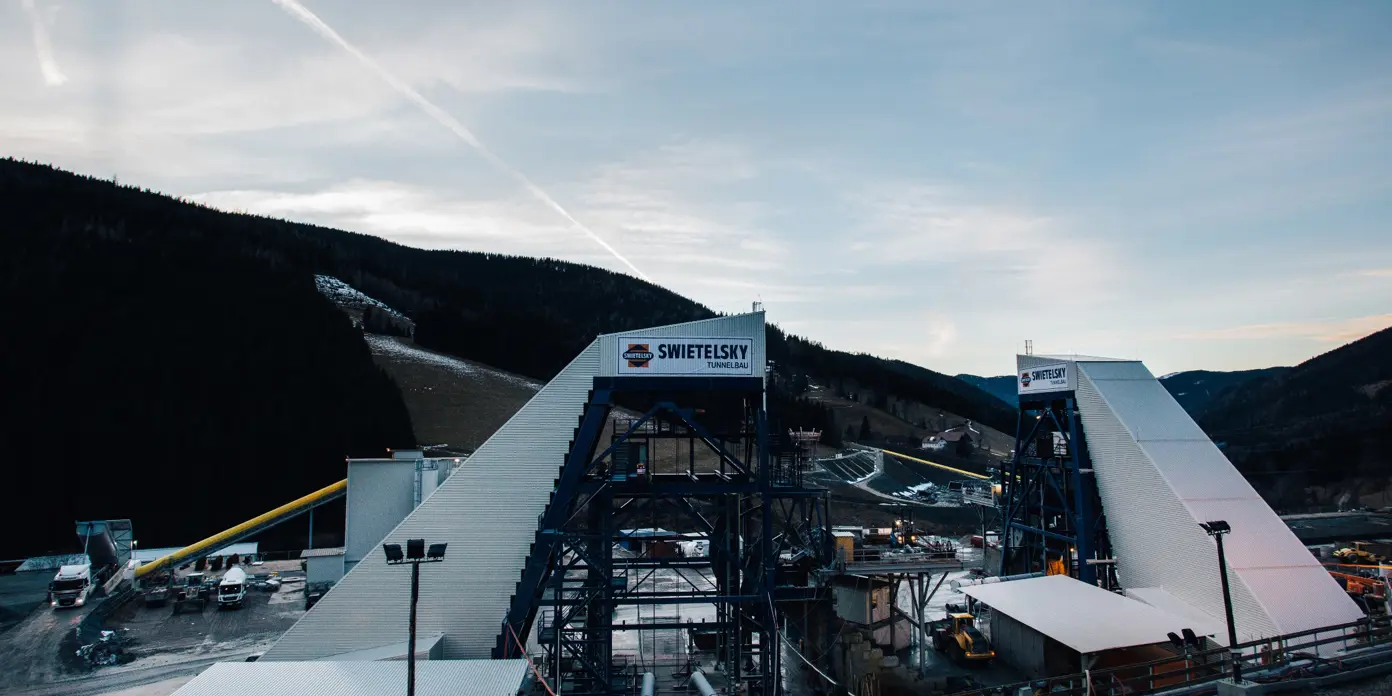

Technical Masterpiece: Complex Vertical Logistics

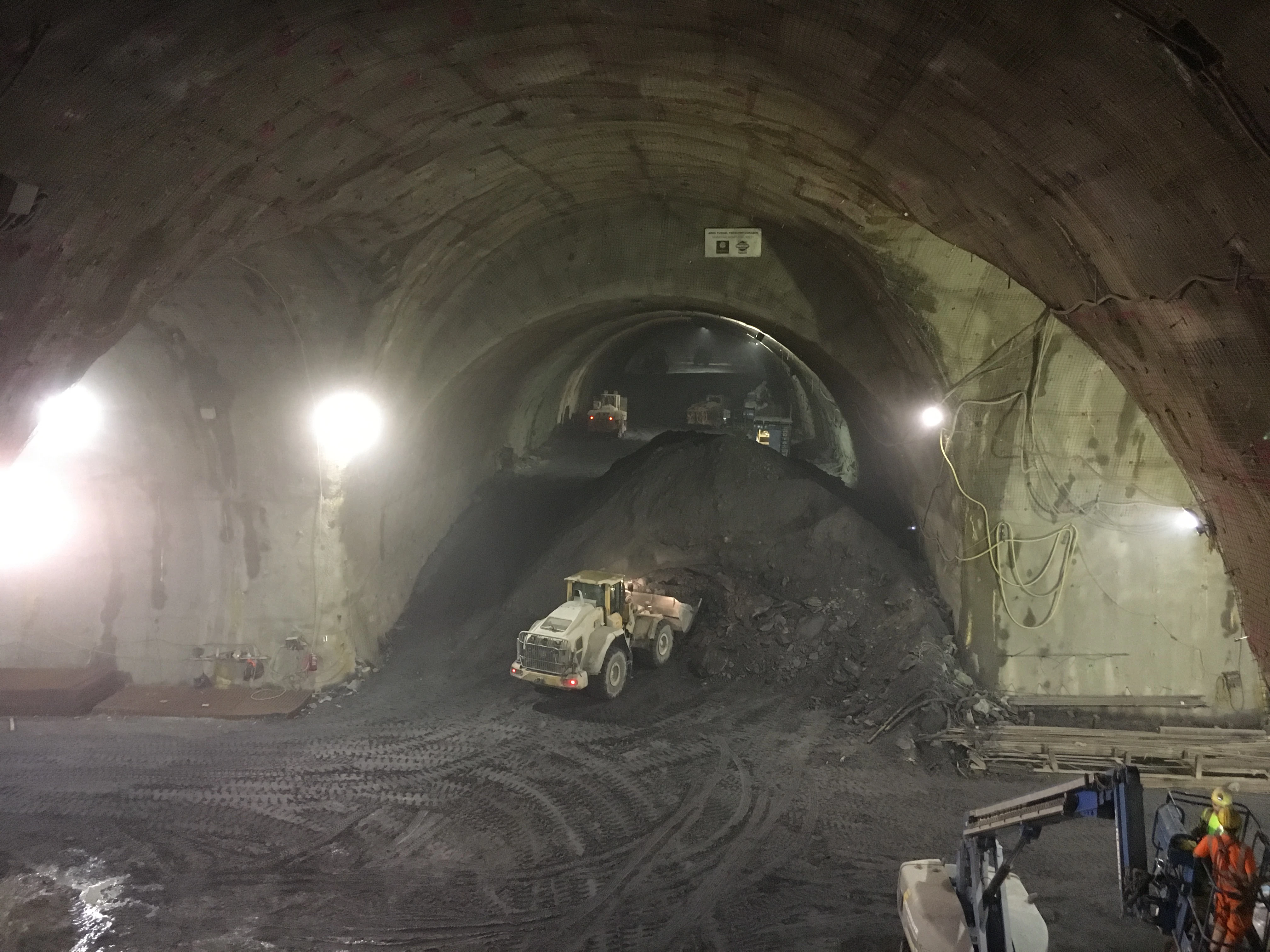

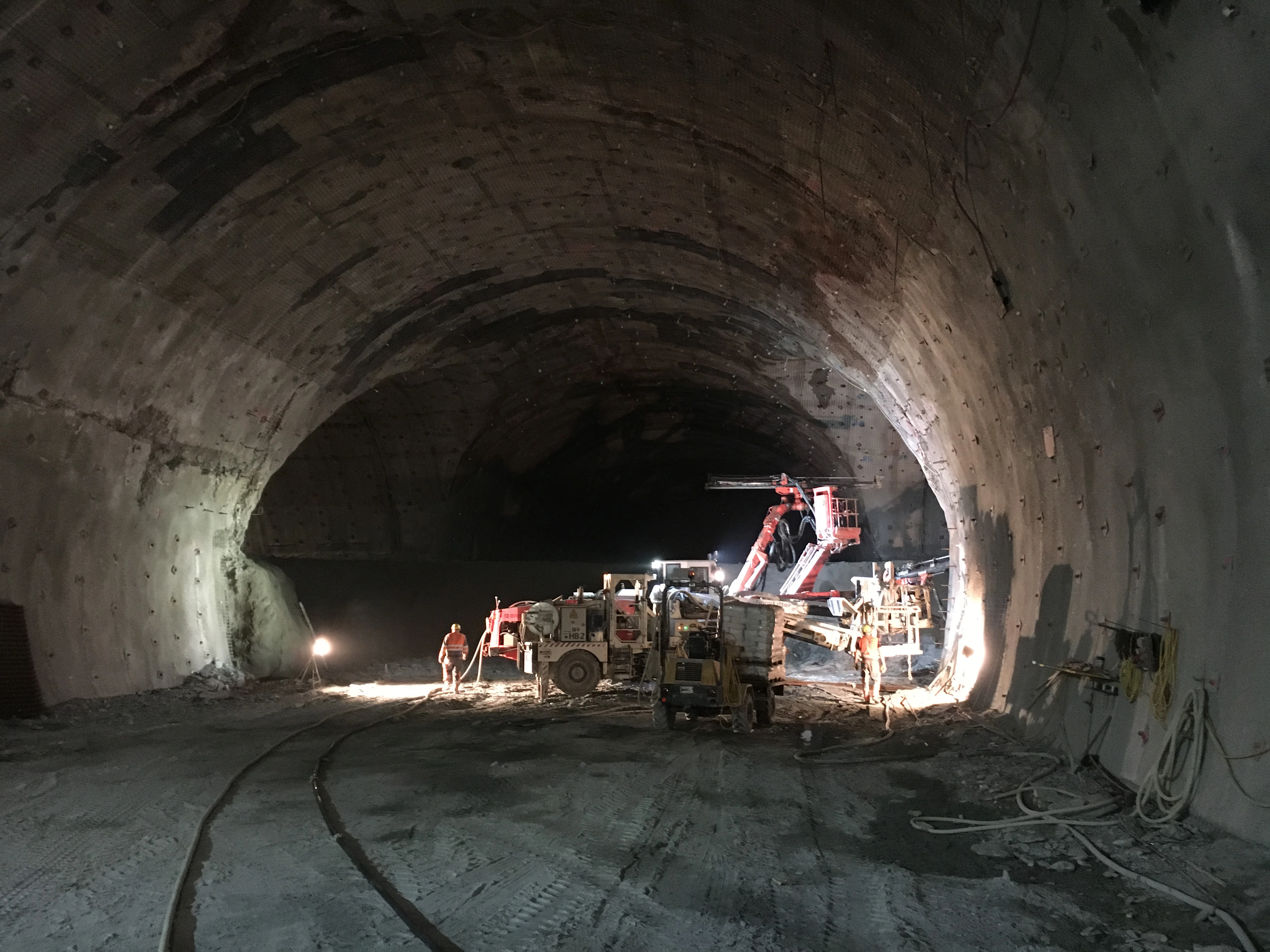

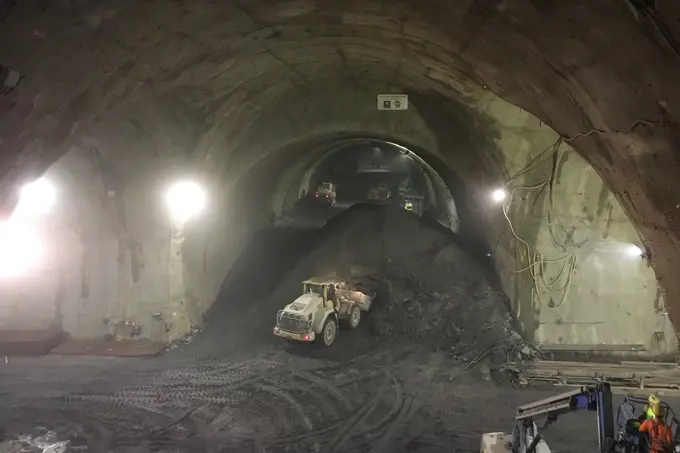

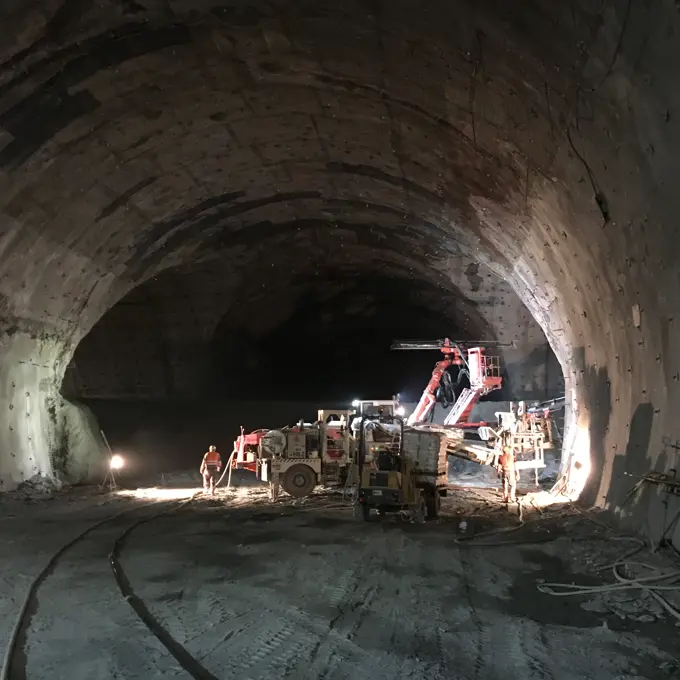

A central characteristic of the Fröschnitzgraben section was accessing the tunnel system via two vertical shafts approximately 400 metres deep. An extensive cavern was excavated at the base of the shaft, which will serve as an underground emergency station during future railway operations.

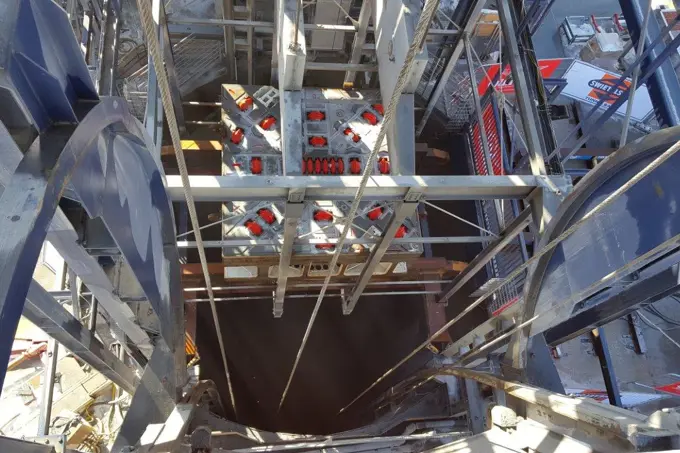

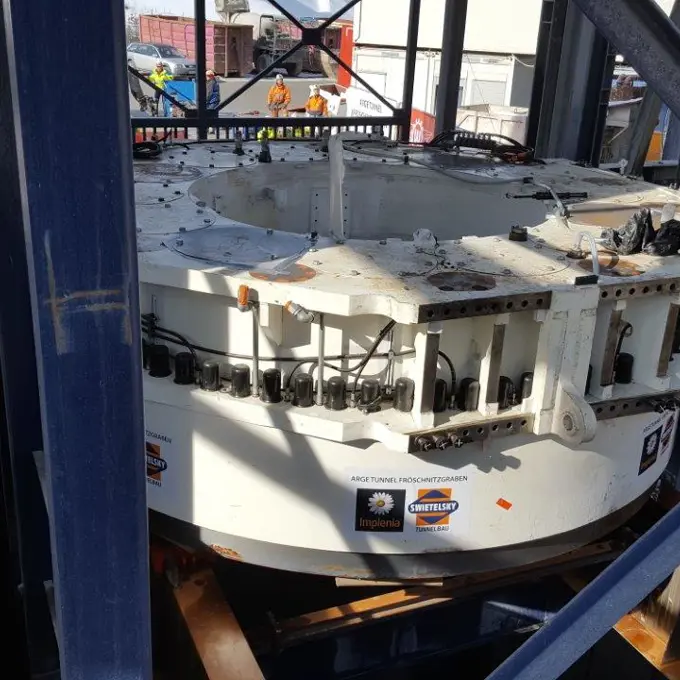

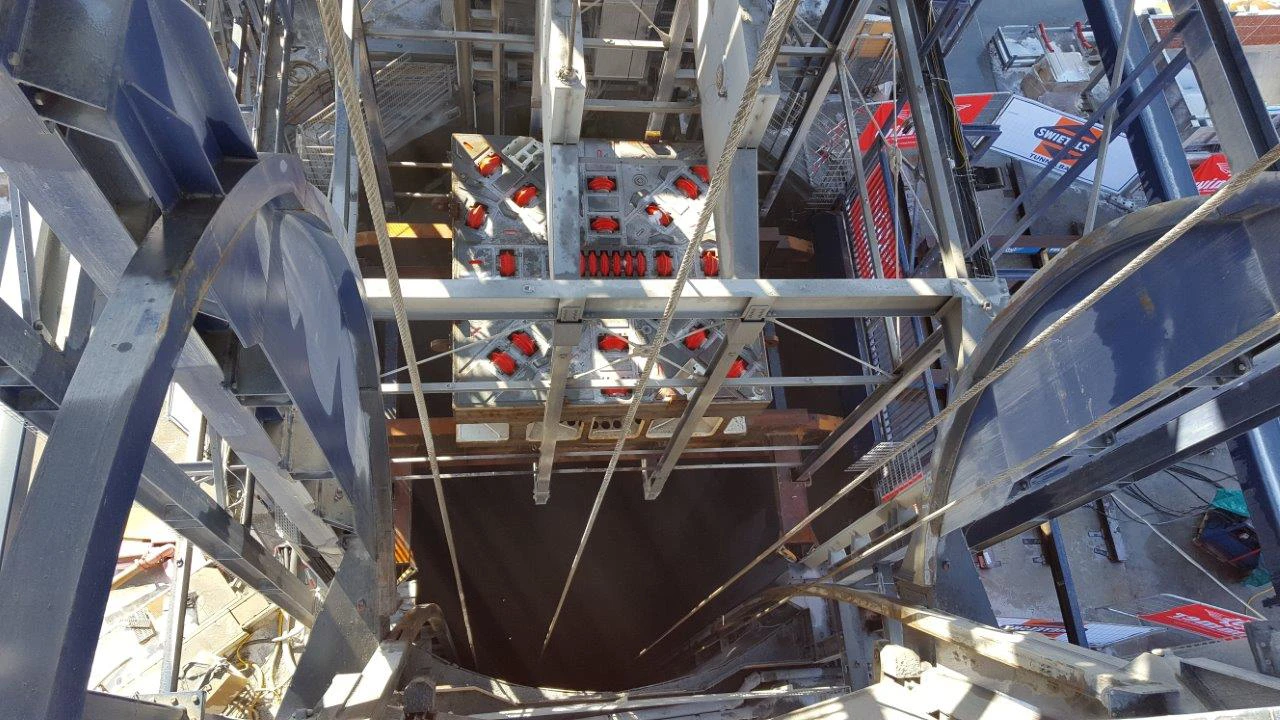

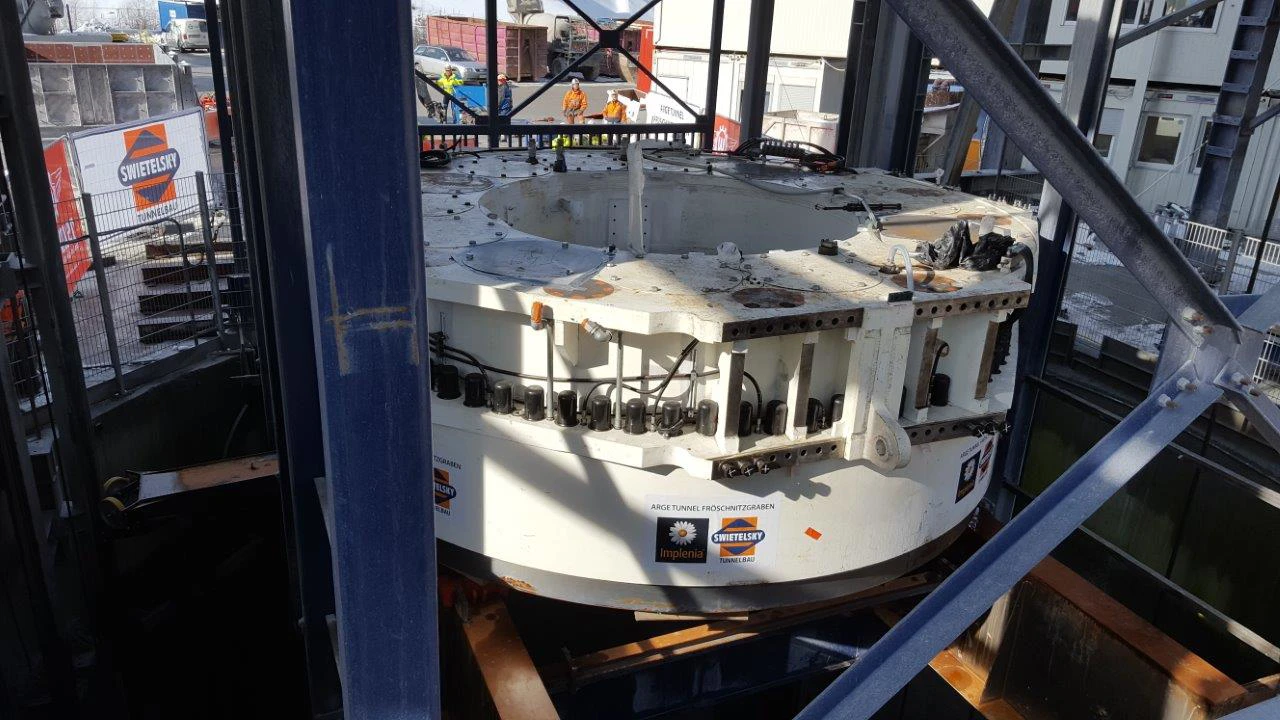

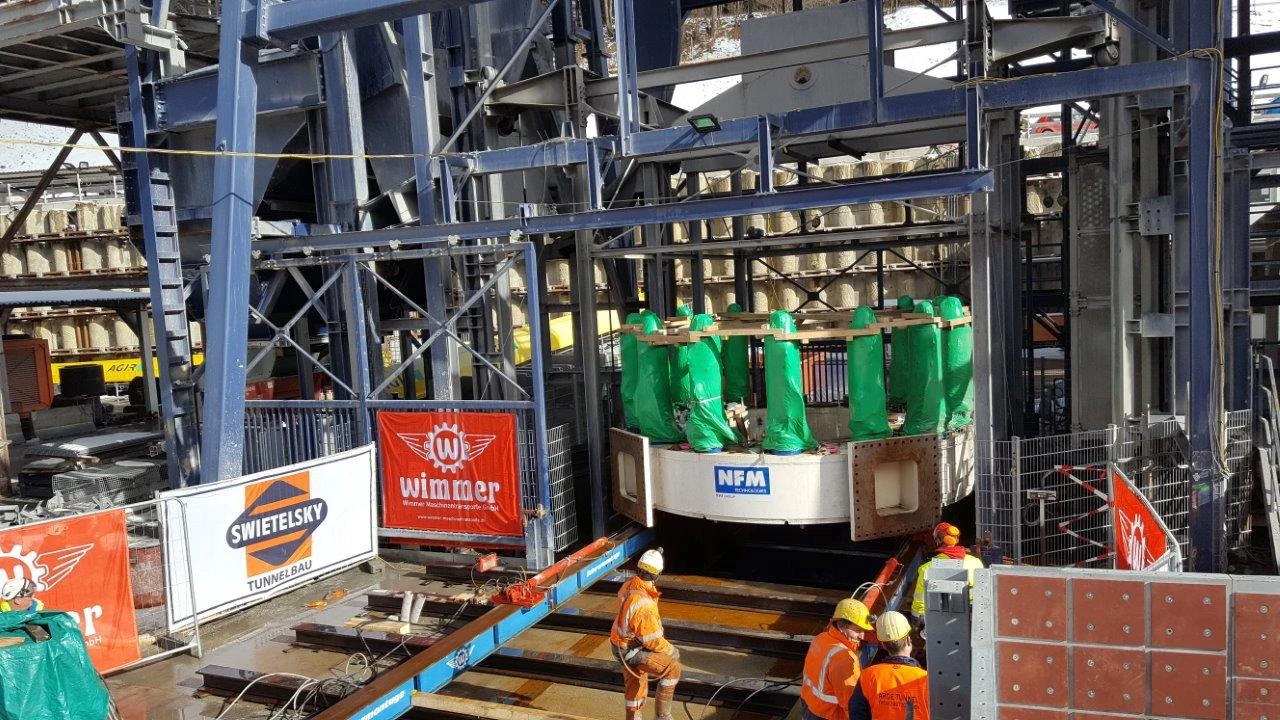

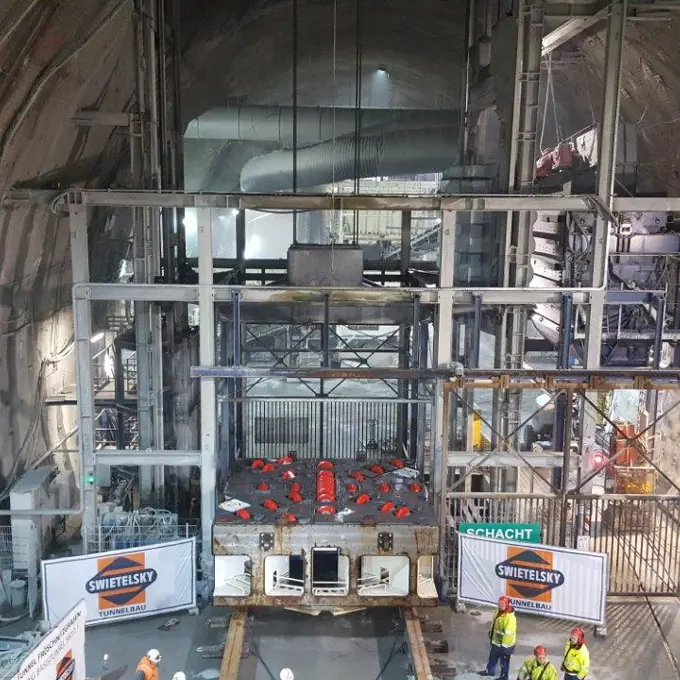

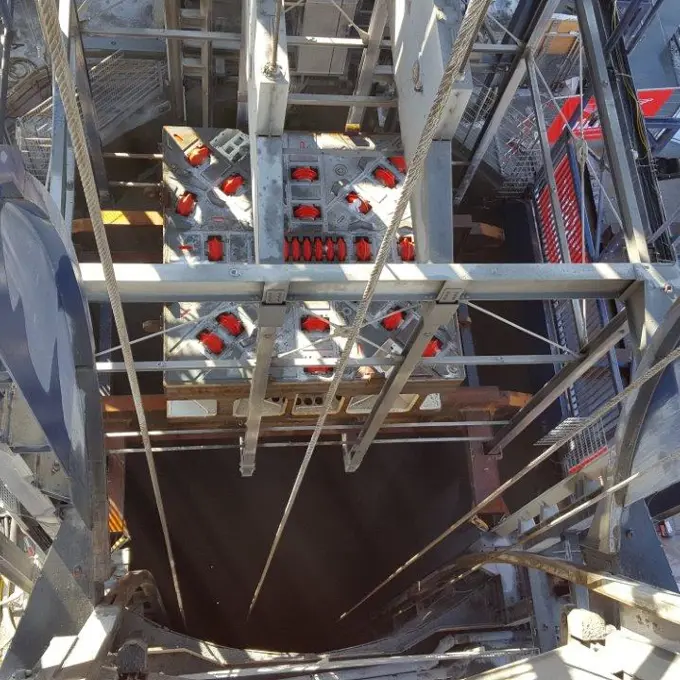

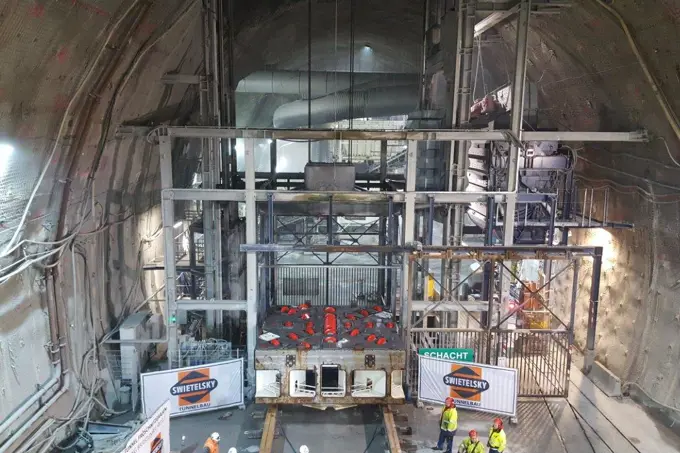

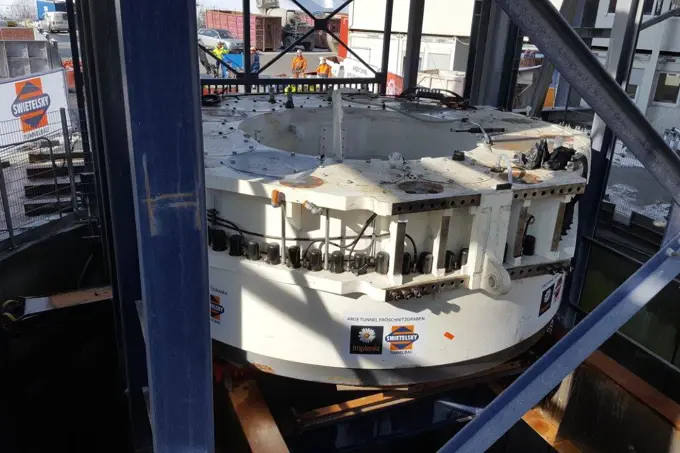

More than five million tonnes of excavated material were hauled up through the shaft hoisting systems, which were also used to lower machinery and building materials. The hoist systems are engineered to handle even the heaviest TBM components, weighing up to 109 tonnes, inside the hoist cage. The installed capacity of the winch systems reached 10,100 kilowatts — equivalent to the power demand of roughly 1,000 single-family homes.

260610 Semmering Basistunnel AT (C)SWIETELSKY (3)

400-Metre Shafts: Precision with Slipforming

During the excavation phase, two approximately 400-metre-deep shafts were used to transport materials into and out of the tunnel. Since then, the original shaft hoisting facilities have been dismantled and the inner concrete lining has been installed. This is achieved using the slipform method, in which the formwork assembly and all associated work platforms move upward continuously.

Specifically, cylindrical slipforming is applied. Hydraulic jacks continuously drive the formwork and its work platforms upward along climbing rods. This process enables a virtually continuous vertical lifting of the formwork structure. As the formwork moves upward, the standard sequence of operations — shuttering, rebar installation, pouring, and curing — is carried out without interruption. Unlike conventional formwork systems, the slipform moves across the entire surface in contact with the concrete. The form lining covers only as much concrete area as necessary for shaping, ensuring that the concrete remains within the formwork long enough to achieve the required strength.

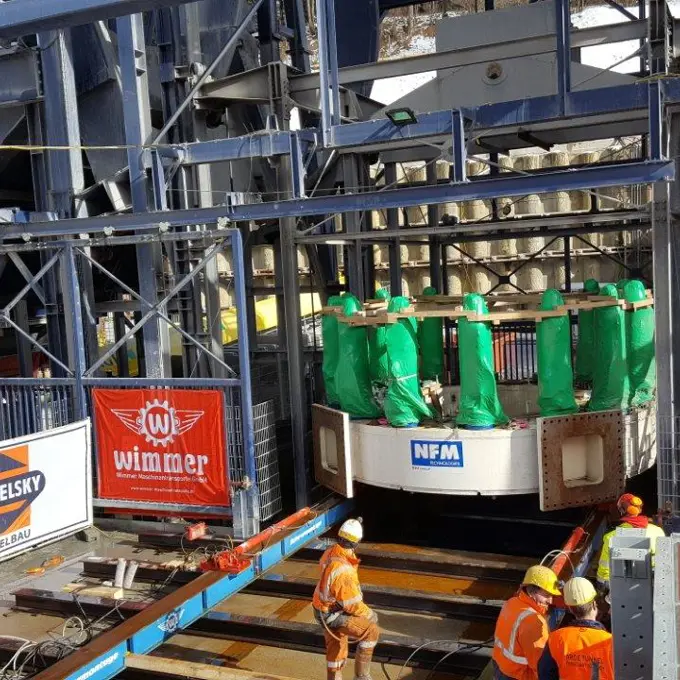

260610 Semmering Basistunnel AT (C)SWIETELSKY (1)

Operations Building and Safety for Rail Operations

During future rail operations, both shafts will fulfill a vital safety function. In the event of a fire, they will serve for smoke extraction and provide a fresh air supply to the underground emergency station.

The ventilation systems required for this purpose will be housed in a purpose-built operations building. This complex industrial structure, with a gross volume of around 15,000 m³, is being constructed in-house. For future inspection and maintenance, Swietelsky Tunnelbau is installing proprietary rope-guided shaft inspection hoists equipped with a personnel transport cage and an integrated maintenance platform.

Remaining Works until October 2027

Following the defect-free handover of tunnel section Lot 2.1 Fröschnitzgraben at the end of April 2026, Swietelsky Tunnelbau will execute the following remaining tasks through October 2027:

· Slipforming of shaft SF2 and the shaft-head building

· Installation of the shaft inspection systems

· Complete clearance of the construction site

Project Profile

· Project: Semmering Base Tunnel

· Location: Lower Austria / Styria

· Duration: Through 2030

· Scope/Responsibility: Tunnelling / Heavy Civil Engineering

· Services / Scope of Work: Concreting of 50 km of tunnel inner lining │ Haulage of 5 million tonnes of excavated material │ Construction of a large cavern │ Mechanical (excavator) and drill-and-blast tunnelling

· Key Specs: 13 km tunnel length │ Two vertical shafts ~400 m deep │ 10,100 kW hoisting winch installations
